** Big data center computer room cleaning

** Big data center computer room cleaning
Table of contents
Chapter 1: The Current Situation of Data Center in Shenzhen Big Data Center
1. Customer specific needs:
2. Specific implementation plan for computer room cleaning services:
3. Principles of dust removal in computer room:
4. Construction progress of fine cleaning service:
1. Preparation work before construction:
2. Project progress plan and measures
2.1.1 Project Progress Plan
2.1.3. Human resources
2.1.4. Project progress measures
2.1.4.1. Construction progress schedule
2.1.4.2 Formulation of project construction progress goals
2.1.4.3. Engineering construction progress management method
2.1.4.4 Project construction progress control method
2.1.4.5. Project construction progress plan
2.1.4.6. Construction Progress
5. Construction personnel arrangements for fine cleaning service:
(1) Personnel composition:
6. Fine cleaning service process:
(I) Areas for customer cleaning services:
(2) The scope and content of dust removal in different areas are formulated as follows:

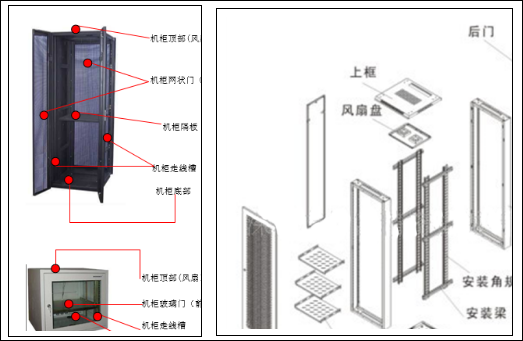

1.) Dust removal of servers and network cabinets:

2.) Dust removal of Ups host and battery:

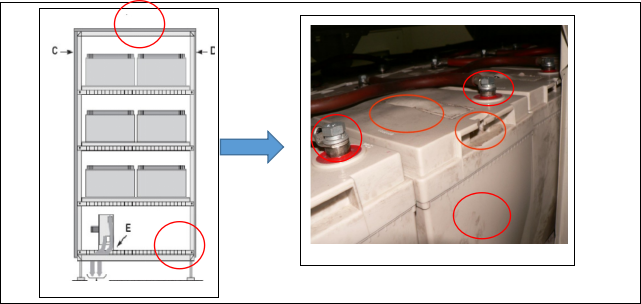

3.) Cleaning contents of UPS batteries and battery cabinets:
4.) Cleaning and dust removal of precision air conditioners:
5.) Cleaning and dusting of bridge trays and cables:
6.) Constant temperature and humidity unit

7.) Horizontal air-cooled direct expansion fresh air fan
8.) Distribution cabinet:
9.) Low voltage distribution cabinet:
10.) 10KV high-pressure chiller frequency converter cabinet:
11:) Fire extinguishing agent bottle set:
12:) ABS air sampling pipe
13:) High voltage cabinet:
14:) Transformer:
15:)Other rooms and public areas:
※For areas that are not IT rooms, since the ground is not an overhead electrostatic floor:

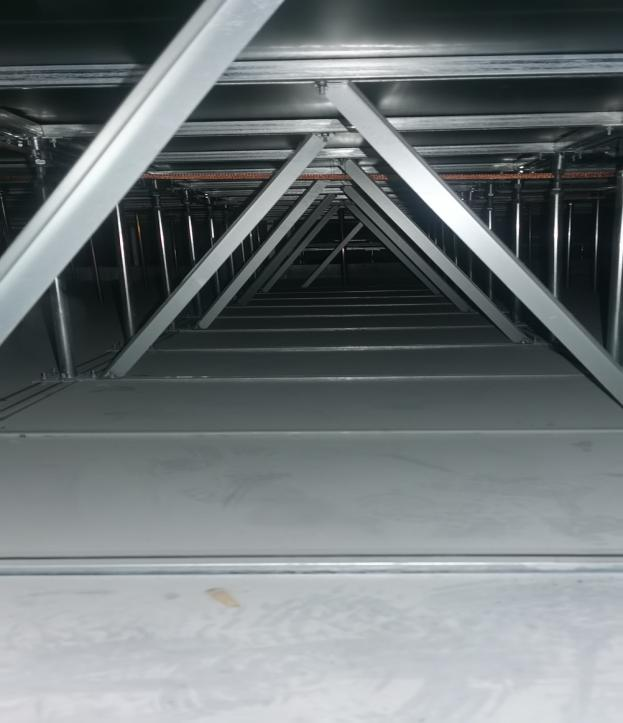

※For the area of the IT computer room, there is an overhead electrostatic floor:
① Contents of electrostatic floor cleaning:
②Cleaning of elevated floor system
7. Tools and equipment for fine cleaning service construction:
(I) Introduction to equipment for the construction of fine cleaning service (partial)
8. On-site protection of fine cleaning services:
Attachment 1: Related standards for computer room construction and their sources
Shenzhen Big Data Center--Computer Room Professional Dust Removal
Service plans and introductions for this project (understanding of this project, progress plan, personnel arrangement, on-site management, service processes and technical requirements, tools and equipment for use, on-site protection measures, risk prevention, acceptance plans, etc.)
Chapter 1: The Current Situation of Data Center in Shenzhen Big Data Center

1. Customer specific needs:
The data center's land reclamation and cleaning area is about 156,000 square meters, and the office supporting areas are about 95,000 square meters.
The specific situation is as follows:
The data center is designed in accordance with the A-level standard in the "Data Center Design Code" GB50174-2017.
The cleaning service is roughly divided into 8 floors + roof of Data Center No. 4, 8 floors + roof of Data Center No. 5, 8 floors + roof of Data Center
No. 6, 8 floors + roof of Data Center No. 10. 10 floors + roof of Office Building No. 11. 5 floors + roof of Dormitory Building No. 12. 11 floors. Other
annexes. All rooms on the 1st floor of the room, cabinets, bridge trays, electrostatic floors, bridge trays of the aisle and floor of the aisle.
序号 | 区域 | 建筑 | 楼层 | 建筑面积 (各楼层建筑面积见附表1) | 开荒清洁部位 | 机柜 数量 |
1 | 数据中心区域(含建筑内相关设施设备) (156539.24㎡) | 4号数据中心 | 8层+屋面 | 24331.58㎡ | 1、数据机房区域:包括但不限于数据机房、弱电机房、运营商机房、弱电间等。 2、动力保障区域:包括但不限于配电室、公用配电房、柴发并机室、制冷控制室、电池室、强电间、冷却塔配电间、配电间、柴发机房、油箱、消防设备间、气瓶间、高压细水雾间、电梯机房、制冷站、空调间、蓄冷站、水泵房、空调补水池、空调管道井、新风机房、排风机房、加压送风机房、排烟机房、排风消音室、油管井、预作用阀门间等。 3、其他公共区域:除上述区域外的其他区域,包括但不限于公共通道、公共洗手间、其它设备用房、电梯、强弱电井等。 | 2128个 |
2 | 5号数据中心 | 8层+屋面 | 24331.58㎡ | 2069个 | ||
3 | 6号数据中心 | 8层+屋面 | 24331.58㎡ | 2202个 | ||
4 | 7号数据中心 | 9层+屋面 | 41772.25㎡ | 4237个 | ||
5 | 8号数据中心 | 9层+屋面 | 41772.25㎡ | 4480个 | ||
6 | 办公配套区域(含建筑内相关设施设备) (95785.68㎡) | 9号运维楼 | 8层+屋面 | 48340.24㎡ | 包括但不限于公共区域(大堂、洗手间、茶水间、通道、电梯、玻璃幕墙内侧等)、办公室、监控室、会议室、设备房、库房、井道等。其中一层运营商机房(285㎡)、负一至七层弱电间(437㎡)及设备间(135㎡)等有设备的房间按照数据中心区域开荒验收标准开荒。 | 44 |
7 | 园区总控中心(ECC) | 3层 (层高6米) | 2009㎡ | 包括但不限于中控大厅(485㎡×2个)、监控室、参观厅、决策室、会议室、公共区域(大堂、洗手间、通道、电梯、玻璃幕墙内侧等)等。 | / | |
8 | 10号综合楼 | 10层+屋面 | 19819.7㎡ | 包括但不限于公共区域(大堂、展厅、洗手间、茶水间、通道、电梯、玻璃幕墙内侧等)、办公室、会议室、设备房、井道等。 | / | |
9 | 11号办公楼 | 5层+屋面 | 8177㎡ | 包括但不限于楼层公共区域(大堂、洗手间、茶水间、通道、电梯、玻璃幕墙内侧等)、办公室、会议室、报告厅、设备房、井道等。 | / | |
10 | 12号宿舍楼 | 11层 | 15439.74㎡ | 包括但不限于楼层公共区域(大堂、洗手间、洗衣房、通道、电梯、玻璃幕墙内侧等)、餐厅、厨房、宿舍、布草间、洗衣房、设备房、井道等。 | / | |
11 | 其他附属建筑 | 1层 | 2000㎡ | 包括但不限于管廊、消防中控室、健身房、客户商务中心、安保岗亭、库房等。 | / |
Principles of dust removal in the computer room:
Given our case and construction experience in the dust removal industry, we have gained valuable experience in our understanding and
implementation of the information system of data centers.
The valuable experience we have gained is:
1. Cleaning principle: first the primary equipment, then the key equipment.
2. First make basic business equipment, then make core equipment. (For hot backup dual-machine equipment, clean all backup machines first, and
then unify the principle of cleaning the main machine.
3. First clean the equipment in the spare computer room, and then implement the principle of the main computer room.
4. The cleaning principle of the computer room: from high to bottom, from the outside to the inside (first start cleaning from the peripheral
environment of the computer room, start from the bridge, then clean the cabinet, and then clean the equipment.) The cabinet starts from the top and to the bottom.
5. Server and other devices follow the principles from front to back, from outside to inside: from outside the server case, server front panel, server
internal, server power supply, server rear panel)
6. Ups cleaning principle: first the battery, then the host machine.
7. Principles for cleaning electrostatic floors: first clean the underground and beams of the electrostatic floor, and finally make the surface of the
electrostatic floor. Adopt cover technology.
8. Clean one device and protect one to avoid contamination from each other. Masking technology is adopted.
4. Construction progress of fine cleaning service:
1. Preparation work before construction:
(1) Data center area, data center No. 4.8 floor, data center No. 5.8 floor, data center No. 6.8 floor, and data center No. 6.8 floor, the floor of each
computer room with electrostatic floor must be laid with coverings to protect electrostatic floors.
(2) All cabinets and battery racks in the computer room must be masked for protection and isolation.
(3) The doors of all rooms in the data center area, data center No. 4.8 floor, data center No. 5.8 floor, and data center No. 6.8 floor, masking technology
is used to isolate each room and the aisle, due to secondary pollution caused by construction.
2. Project progress plan and measures
2.1.1 Project Progress Plan
The construction progress is ensured by using a three-level quality inspection system of the construction team, project department, and company quality inspection department.
三级质量检查制度 | ||
第一级 | 施工队自检 | (1)在施工前、施工中、施工后,根据施工规范进行自检。 (2)做好质量记录,保证质量记录真实、全面、具有可追溯性。 (3)做好关键工序和隐蔽工程随工签证,严把质量关。 (4)若检查出质量问题,应督促施工人员现场整改,并形成质量记录。 |
第二级 | 项目部检查 | (1)制定本项目部的质检计划,并推动施工作业层质检人员对质量检验计划的执行。 (2)检查施工层面的质量记录,随工签证。 (3)抽查施工流程中的工程质量,对关键工序、质量控制点的质量作重点检验和督察。 (4)听取监理和业主单位对施工质量检验的意见,发生质量偏差时,督促施工队进行整改,并做好记录。 |
第三级 | 公司质检部 | (1)完善质量内控流程,保证质量保证体系的有效运转。 (2)对项目部和施工队的质检工作情况和质量记录进行抽检和核实。 (3)对关键工序、质量控制点的质量进行抽查。 (4)对监理单位和业主单位进行回访,听取监理和业主单位对施工质量检验的意见,处理工程质量投诉,督促项目整改。 |
检查标准 | ||
第一级 | 施工队自检 | ISO-9001:2008质量管理体系 各项工程建设管理制度、办公司质量手册和程序文件 |
第二级 | 项目部检查 | |
第三级 | 公司质检部 | |
检查范围 | ||
第一级 | 施工队自检 | 100%检查 |
第二级 | 项目部检查 | 70%检查 |
2.1.3. Human resources
In order to organize the construction reasonably, based on the characteristics of the project and the long-term construction management experience of our company, we plan to invest in: 1 project manager, 10 construction workers, 1 safety officer, a total of 12 people.
If the construction period is shortened due to delayed arrival of materials, we can also send additional reserve construction teams to meet the project needs. Statistics of personnel to be dispatched
序号 | 拟派人员岗位 | 拟派人数 | 备注 |
1 | 项目负责人 | 2人 | |
3 | 安全员 | 1人 | |
9 | 施工人员 | 40人 | |
10 | 合计 | 43人 |
2.1.4. Project progress measures
2.1.4.1. Construction progress schedule
This project is an annual bidding. Our project construction is carried out strictly in accordance with the following promised time:
Construction unit entry time: strictly implement it in accordance with the owner's requirements
Completion date: strictly follow the owner's requirements
Total construction period: strictly implement it in accordance with the owner's requirements.
The progress plan shall be adjusted appropriately according to the contract construction period, and the specific start-up and completion date shall be implemented according to the requirements of the construction unit.
2.1.4.2 Formulation of project construction progress goals
Before carrying out project progress management, the management team will plan progress management in advance as a
summary and outline of the project management plan.
The following management process groups will be involved in the progress management process of engineering projects,
and the basis, tools and results will be involved in several project progress management activities or processes.
Ø Activity definition
Determine project deliverables and provide a basis for project progress estimation, arrangement, implementation and
monitoring. During the process of defining the progress management activities of this project, the project work combination
is further broken down into smaller and easier to manage based on factors such as the resource conditions of each area and
the external environment, based on factors such as the resource conditions of each area and the external environment, and the
project work combination is further broken down into smaller and easier to manage planning activities, providing detailed
information for further clarifying the work content, thereby obtaining a list of work content for the progress management
of this project and clarifying the management tasks.
Ø Activity sorting
Identify the list of known activities and record the logical relationship between planning activities. Appropriately consider
logical relationships such as tight front, tight back, advance, and lag, and formulate a practical project schedule. In terms of
consideration and arrangement of logical relationships, fully use computers and project management software to work to
improve work efficiency and avoid errors.
Ø Activity resource estimation
Determine what resources to use during project implementation, the number of each resource to be used, and the time it
takes to be invested in the project. When allocating and estimating to project activities, economics must be taken into account
and the principle of meeting project requirements and saving costs must be achieved. Determining the type and number of
resources is the basis for resource consumption time.
Ø Activity resource duration estimate
The estimation of resource duration is a process of gradual refinement and improvement. We must fully consider the
accuracy of the original data. Whether the original data is accurate is crucial to the accuracy of the activity plan estimation.
The estimation table needs to have a certain range, providing a solid foundation for formulating a progress plan.
Ø Develop a project schedule
Based on the definition and sorting of project activities, the estimated resource requirements and investment time of the
project, a construction progress plan will be formulated. Use network analysis technology, key line method, progress
compression technology, hypothesis scenario analysis, resource balance chart, key chain technology, etc. to obtain the
project schedule. Provide an important basis for project progress control.
2.1.4.3. Engineering construction progress management method
We plan to use the following methods to comprehensively control the progress management of this project to ensure the
smooth development of the project, implement it according to the progress, complete the planned progress goals, and
deliver it to the construction party for use on schedule.
Ø Gantt chart (cross-track chart) method
Ø Critical Path Method
Ø Plan Review Method
2.1.4.4 Project construction progress control method
The construction stage is the formation stage of the engineering entity and the stage in which we implement the prepared
construction progress plan.
Ø Decompose according to the construction stage to highlight the control nodes.
Taking key lines and sub-critical lines as clues, and using the planned starting and end milestones as control points, key control
objects are determined at different construction stages, and construction details are formulated to ensure the realization of the control nodes.
Decompose according to professional job types and determine the handover time.
Ø Comprehensive balance between tasks of different majors and different types of jobs, emphasize mutual coordination and
coordination, determine the date of mutual handover, strengthen the seriousness of the construction period, and ensure that
the progress does not cause delays in this process. The quality and time of each process are controlled to ensure the progress
of each branch project.
According to the time requirements of the total progress plan, the overall construction progress plan is broken down into
weekly and daily plans, and dynamic control of the progress plan is implemented.

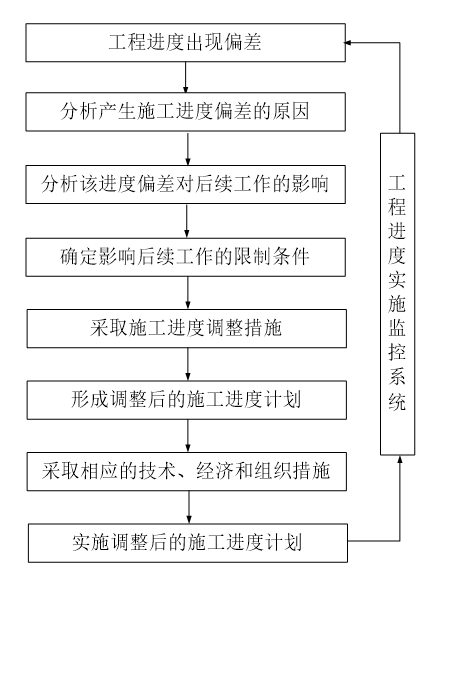

Dynamic control cycle diagram of construction progress

2.1.4.5. Construction schedule plan

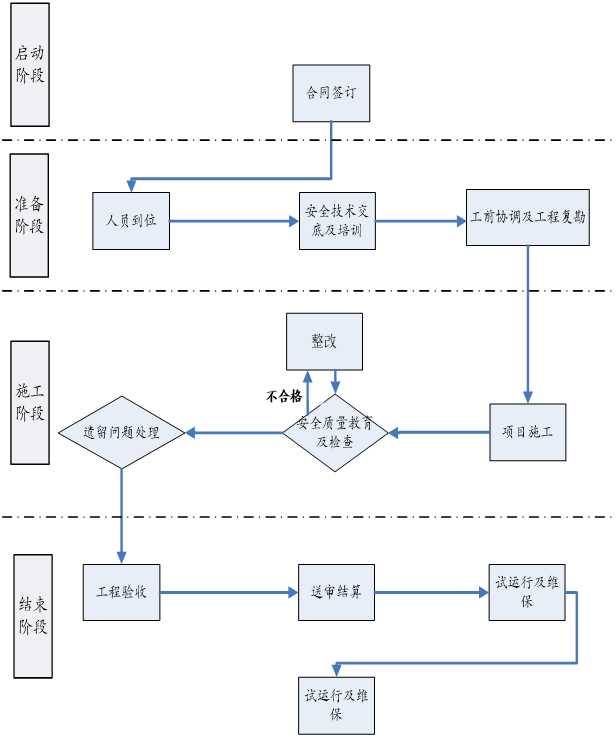

Project task decomposition
项目从启动、准备、施工、结束四大阶段进行任务分解。
分解表
序号 | 工作包名 | 工作包内容 | 备注 |
1 | 合同签订 | 按流程进行合同和订单的签署 | |
2 | 人员到位 | 根据工程内容和任务分解进行资源估算,配置合适人力 | |
3 | 安全技术交底及培训 | 三级技术交底,确保安全文明施工 | |
4 | 工前协调及工程复勘 | 进行协调和复勘 | |
5 | 项目施工 | 按工序施工,详见工序分解 | |
6 | 安全质量教育及检查 | 根据三级交底进行安全控制 | |
7 | 资管完善 | 按要求完善资管系统 | |
8 | 遗留问题处理 | 处理各系统遗留问题,达到验收条件 | |
9 | 工程验收 | 完善资料进行工程验收 | |
10 | 送审结算 | 认真统计工作量,严肃送审,控制审减 |
大数据中心的机房除尘-施工进度计划表横道图 | |||||||||||
施工进度(20**-07-15开始到20**-08-23结束,施工时间38天) | |||||||||||
施工单位: | 成都意深特科技有限公司 | 地址: | - |
开工日期:
| 2023-7-15 | ||||||
序号 | 清洁区域 | 开始时间 | 结束时间 | 施工天数 | 10天 | 10天 | 10天 | 10天 | 10天 | 10天 | 8天 |
1 | 4号楼8层 | 2023-7-15 | 2023-7-25 | 10 | |||||||
2 | 5号楼8层 | 2023-7-25 | 2023-8-5 | 10 | |||||||
3 | 6号楼8层 | 2023-8-5 | 2023-8-15 | 10 | |||||||
4 | 10号综合楼,10层 | 2023-7-15 | 2023-7-25 | 10 | |||||||
5 | 11号办公楼.5层 | 2023-7-25 | 2023-8-5 | 10 | |||||||
6 | 12号宿舍楼,11层 | 2023-8-5 | 2023-8-15 | 10 | |||||||
7 | 其他附属建筑.1层 | 2023-8-15 | 2022-8-23 | 8 | |||||||
序号 | 区域 | 建筑 | 楼层 | 建筑面积 (各楼层建筑面积见附表1) | 开荒清洁部位 | 机柜 数量 |
1 | 数据中心区域(含建筑内相关设施设备) (156539.24㎡) | 4号数据中心 | 8层+屋面 | 24331.58㎡ | 1、数据机房区域:包括但不限于数据机房、弱电机房、运营商机房、弱电间等。 2、动力保障区域:包括但不限于配电室、公用配电房、柴发并机室、制冷控制室、电池室、强电间、冷却塔配电间、配电间、柴发机房、油箱、消防设备间、气瓶间、高压细水雾间、电梯机房、制冷站、空调间、蓄冷站、水泵房、空调补水池、空调管道井、新风机房、排风机房、加压送风机房、排烟机房、排风消音室、油管井、预作用阀门间等。 3、其他公共区域:除上述区域外的其他区域,包括但不限于公共通道、公共洗手间、其它设备用房、电梯、强弱电井等。 | 2128个 |
2 | 5号数据中心 | 8层+屋面 | 24331.58㎡ | 2069个 | ||
3 | 6号数据中心 | 8层+屋面 | 24331.58㎡ | 2202个 | ||
4 | 7号数据中心 | 9层+屋面 | 41772.25㎡ | 4237个 | ||
5 | 8号数据中心 | 9层+屋面 | 41772.25㎡ | 4480个 | ||
6 | 办公配套区域(含建筑内相关设施设备) (95785.68㎡) | 9号运维楼 | 8层+屋面 | 48340.24㎡ | 包括但不限于公共区域(大堂、洗手间、茶水间、通道、电梯、玻璃幕墙内侧等)、办公室、监控室、会议室、设备房、库房、井道等。其中一层运营商机房(285㎡)、负一至七层弱电间(437㎡)及设备间(135㎡)等有设备的房间按照数据中心区域开荒验收标准开荒。 | 44 |
7 | 园区总控中心(ECC) | 3层 (层高6米) | 2009㎡ | 包括但不限于中控大厅(485㎡×2个)、监控室、参观厅、决策室、会议室、公共区域(大堂、洗手间、通道、电梯、玻璃幕墙内侧等)等。 | / | |
8 | 10号综合楼 | 10层+屋面 | 19819.7㎡ | 包括但不限于公共区域(大堂、展厅、洗手间、茶水间、通道、电梯、玻璃幕墙内侧等)、办公室、会议室、设备房、井道等。 | / | |
9 | 11号办公楼 | 5层+屋面 | 8177㎡ | 包括但不限于楼层公共区域(大堂、洗手间、茶水间、通道、电梯、玻璃幕墙内侧等)、办公室、会议室、报告厅、设备房、井道等。 | / | |
10 | 12号宿舍楼 | 11层 | 15439.74㎡ | 包括但不限于楼层公共区域(大堂、洗手间、洗衣房、通道、电梯、玻璃幕墙内侧等)、餐厅、厨房、宿舍、布草间、洗衣房、设备房、井道等。 | / | |
11 | 其他附属建筑 | 1层 | 2000㎡ | 包括但不限于管廊、消防中控室、健身房、客户商务中心、安保岗亭、库房等。 | / |

Clean the front and rear doors of the cabinet: Disassemble the front and rear doors of the cabinet, and clean the surface of the cabinet with special cleaning liquid for communication equipment and anti-static tablecloth. Mainly cleans the dust on the empty cabinet door.
‚Cleaning the top of the cabinet: First, use a low-power vacuum cleaner (800W) to clean the dust on the top of the cabinet, then use a special cleaning liquid for communication equipment and a rag, and finally blow dry with a wind blower.
③ Clean the sides of both sides of the cabinet: Use special cleaning liquid for communication equipment and a rag to clean the dust.
④ Clean the bottom of the cabinet: Use a low-power vacuum cleaner (800W) to clean the dust at the bottom of the cabinet, then use a special cleaning liquid for communication equipment and a rag, and finally blow dry with a wind blower.
⑤ Cleaning of cabinet fans: Rinse the fan blades with special cleaning sprays, and remove residual dust with anti-static brushes.
Remark:
*Special cleaning solution for communication equipment: It is a quick-drying, eliminating static electricity on the cabinet and eliminating liquid. Colorless and odorless, such as the electrostatic cleaning liquid of Baolifu in the United States.
*For the cabinets that are installed on the equipment: First, use an electrostatic ion air gun and an adjustable electrostatic high-voltage dust collector to deal with the inside and outside the cabinet.
2.) Dust removal of Ups host and battery:
3.1.1.UPS主机的清洗内容:
UPS主机的顶端,底下。
‚UPS的门的内侧和外侧。
③针对UPS主机内部的控制电路板,电容,电气连接器,无法接触的区域,采用保守的吹风处理,并用吸收器进行微粒吸取。
Note: UPS host cleaning process and process:
Before cleaning the UPS host, make sure that the cleaning staff wears electrician insulated gloves to prevent electric shock accidents during cleaning.
‚ First use a mini vacuum cleaner and use an anti-static brush to absorb large dust in the UPS host.
ƒUse special electrical cleaning solution and combined with an anti-static desktop to remove oil and stubborn stains on the UPS host.
④ Then use a special electrostatic elimination spray and combine it with an anti-static tablecloth to eliminate dust and static electricity on the mainframe housing.
⑤ For dust on the circuit board on the UPS host, use an anti-static brush and a vacuum cleaner to deal with the dust.
3.) Cleaning contents of UPS batteries and battery cabinets:
UPS电池柜的顶端和底端,以及电池柜的内侧的灰尘。
‚UPS的电池壳体表面。
ƒUPS的电池接线桩。
备注:UPS电池和电池柜清洗工艺和流程
First, before cleaning the UPS battery and battery cabinet, the cleaning staff wears special electrician gloves to avoid electric shock.
‚ First use a mini vacuum cleaner and use an anti-static brush to absorb the large amount of dust on the UPS battery cabinet and the battery.
ƒUse a dedicated communication online cleaning agent and an anti-static table cloth to treat remaining dust on the surface and inner side of the UPS cabinet, as well as the surface of the UPS battery.
④ Use special anti-static sprays and combined with anti-static tablecloths to eliminate the remaining dust in the UPS battery cabinet and the static electricity of the electromagnetic shell, and at the same time eliminate static electricity on the UPS battery cabinet.
⑤ Use special circuit board online cleaning spray to rinse the dust from the wiring piles of the UPS battery.
⑥ Finally, use a high-power hair dryer to air-dry the UPS battery wiring piles and other parts.
⑦ After cleaning is completed, use an electrostatic tester to test the static value, and use a multimeter to test the UPS battery to see if it is normal. And record the test results.
UPS battery switch cabinet:
Before cleaning the UPS battery switch cabinet, make sure that the cleaning staff wears electrician insulated gloves to prevent electric shock accidents during cleaning.
‚First use an anti-static vacuum cleaner and use an anti-static brush to absorb the large amount of dust in the UPS battery switch cabinet.
ƒUse special electrical cleaning solution and combined with an anti-static desktop to remove oil and stubborn stains on the UPS battery switch cabinet.
④ Then use a special electrostatic elimination spray and combine it with an anti-static tablecloth to eliminate dust and static electricity on the UPS battery switch cabinet shell.
⑤ For dust on the switches on the UPS battery switch cabinet, use an anti-static brush and a vacuum cleaner to deal with the dust.
4.) Cleaning and dust removal of precision air conditioners:
3.2.1. Precision air conditioner cleaning content:
The surface, bottom end and inner side of the housing of the precision air conditioner;
‚Precision air conditioner compressor;
③ Condenser for precision air conditioning;
④ Expansion valve of precision air conditioning;
⑤ Evaporator for precision air conditioning;
⑥ Humidifier for precision air conditioning;
⑦ Drain pipes of precision air conditioners.
Note: Cleaning process and process of precision air conditioning
First use a vacuum cleaner with an anti-static brush to absorb the large dust particles on the top and inside of the air conditioner.
‚Use online cleaning spray and anti-static brushes to clean the shell, inside and bottom of the precision air conditioner, and clean the remaining stains and dust.
ƒ Use a vacuum cleaner to absorb the precision air conditioner aluminum sheet, then use a special air conditioner aluminum sheet cleaning agent, and flush the dust from the evaporator with a quick spray gun. Then, wipe the remaining stubborn stains from the precision air conditioner aluminum sheet using an anti-static tablecloth.
④ Use special electrical cleaning agents and use a quick spray gun to clean the compressor, condenser, expansion valve and oil stains in the air conditioner.
Use an online cleaning agent with an anti-static tablecloth to wipe the compressor condenser and expansion valve of the precision air conditioner to remove remaining stubborn stains.
⑤ Apply anti-static spray to the shell of the precision air conditioner, the air outlet at the top and the bottom to eliminate static electricity.
⑥ Spray reactive oxygen sterilization and algae-killing agent (selected).
5.) Cleaning and dusting of bridge trays and cables:
Summary: Before cleaning the bridge tray, the first thing to do is cover technology (that is, dustproof cotton should be covered on the cabinet. The purpose is to drop dust and particles that fall at any time during the dust removal process of high-altitude bridge tray and ceiling, or equipment in the cabinet, causing secondary pollution.
梯式桥架中的线缆表面和内侧。
‚梯式桥架中固线器和横梁。
③梯式桥架中中的线缆。
备注:桥架和线缆的清洗工艺和流程:
先用无线吸尘器配合防静电刷,吸取线缆上的大的灰尘颗粒。
‚Use a quick spray gun, use a dedicated online cleaner for communication equipment, and a high-power hair dryer to clean the dust on the cable surface.
ƒ Finally spray special electrostatic elimination liquid to eliminate static electricity from the cable.
6.) Constant temperature and humidity unit
① For constant temperature and humidity unit evaporators, compressors, fans, electric adders, humidifiers, etc., use a vacuum cleaner to absorb large dust particles. When using an anti-static rag, wipe it with Chaobao full-function cleaning liquid.
② For the external housing of the constant temperature and humidity unit, first use an anti-static rag and wipe it with Chaobao full-function cleaning liquid.
③For the electrical department of constant temperature and humidity units, we use special communication online sprays to clean the electrical circuits.
④ Use Baolifu's anti-static elimination liquid to eliminate static electricity against the outer shell of the constant temperature and humidity unit.
7.) Horizontal air-cooled direct expansion fresh air fan
① For the main unit of the horizontal air-cooled direct expansion fan, we first use an anti-static vacuum cleaner to absorb dust particles. When using an anti-static rag, wipe the main machine case with Chaobao full-function cleaning liquid.
② For the pipelines of horizontal air-cooled direct expansion fan, Baolifu's anti-static elimination liquid is used, and for the pipelines of horizontal air-cooled direct expansion fan, eliminating static electricity.
8.) Distribution cabinet:
①For the power distribution cabinet host, we first use an anti-static vacuum cleaner to absorb dust particles. When using an anti-static rag, wipe the main machine case with Chaobao full-function cleaning liquid.
②For the electrical parts of the distribution cabinet, special online spray for communication is used to clean the lines.
③ Finally, Baolifu's electrostatic elimination liquid is used and anti-static rags are used to eliminate static electricity in the outer housing of the distribution cabinet.
Note: During construction, be careful to wear electrician insulated gloves.
9.) Low voltage distribution cabinet:
①For low-voltage distribution cabinet hosts, we first use an anti-static vacuum cleaner to absorb dust particles. When using an anti-static rag, wipe the main machine case with Chaobao full-function cleaning liquid.
②For the electrical parts of the low-voltage distribution cabinet, special online spray for communication is used to clean the lines.
③ Finally, Baolifu's electrostatic elimination liquid is used and anti-static rags are used to eliminate static electricity in the outer housing of the low-voltage distribution cabinet.
Note: During construction, be careful to wear electrician insulated gloves.
10.) 10KV high-pressure chiller frequency converter cabinet:
① For the frequency converter cabinet main unit of high-pressure chiller, we first use an anti-static vacuum cleaner to absorb dust particles. When using an anti-static rag, wipe the main machine case with Chaobao full-function cleaning liquid.
②For the electrical parts of the frequency converter cabinet of the high-pressure chiller unit, special online spray for communication is used to clean the lines.
③ Finally, Baolifu's electrostatic elimination liquid is used and anti-static rags are used to eliminate static electricity in the outer housing of the frequency converter cabinet of the high-pressure chiller unit.
Note: During construction, be careful to wear electrician insulated gloves.
11:) Fire extinguishing agent bottle set:
① First, use an anti-static vacuum cleaner to absorbb dust particles from the cylinders of the cylinders of the fire extinguishing agent bottle set.
② Use Baolifu multi-function cleaning agent and combined with an anti-static rag to clean the dust in the shell of the cylinder of the fire extinguishing agent bottle group.
③ Use 3M anti-static elimination liquid to eliminate static electricity from the overall host of the smoke detector area.
12:) ABS air sampling pipe
① First, use an anti-static vacuum cleaner to absorb dust particles from the ABS air sampling tube pipeline.
② Use Baolifu multi-function cleaning agent and anti-static rag to clean the dust in the ABS air sampling pipe.
③ Use 3M anti-static elimination liquid to eliminate static electricity from the ABS air sampling pipe as a whole.
13:) High voltage cabinet:
①For high-voltage cabinet hosts, we first use an anti-static vacuum cleaner to absorb dust particles. When using an anti-static rag, wipe the main machine case with Chaobao full-function cleaning liquid.
②For the electrical parts of the high-voltage cabinet, special online spray for communication is used to clean the lines.
③ Finally, Baolifu's electrostatic elimination liquid is used and anti-static rags are used to eliminate static electricity in the outer housing of the high-voltage cabinet.
Note: During construction, be careful to wear electrician insulated gloves.
14:) Transformer:
①For the transformer host, we first use an anti-static vacuum cleaner to absorb dust particles. When using an anti-static rag, wipe the main machine case with Chaobao full-function cleaning liquid.
②For the electrical parts of the transformer, special online spray for communication is used to clean the line dust.
③ Finally, Baolifu's electrostatic elimination liquid is used and anti-static rags are used to eliminate static electricity in the outer housing of the transformer.
Note: During construction, be careful to wear electrician insulated gloves.
15:)Other rooms and public areas:
序号 | 区域 |
1 | 公共区域走廊、大厅等 |
2 | 办公区 |
3 | ECC |
4 | IT机房 |
5 | 配电室 |
6 | 高压室 |
7 | 电池室 |
8 | 冷站 |
9 | 气消间 |
11 | 柴发室 |
12 | 弱电间 |
※For areas that are not IT rooms, since the ground is not an overhead electrostatic floor:
① First use the stain and wax water to clean the floor. Clean the floor until it is clean with a 154-turn multi-functional floor brushing machine and vacuum water suction machine, and air-dry it with a three-speed air dryer; the floor, etc. are cleaned with a vacuum water suction machine and a clean dust push and electrostatic vacuum cleaner until it is clean;
Select the corresponding wax water according to the floor material, and waxing the floor with a waxing machine, a water press and a wax mop;
l After the wax surface is dried, polish the wax surface;
l Dust removal treatment on the polished ground.
l Make a thorough and comprehensive inspection of the whole to ensure the quality of the project.
②Polishing equipment:
1. Multi-functional floor brushing machine, vacuum and water suction machine, three-speed air dryer, and polishing machine;
2. Water pressing truck, wax drag, dust push, cleaning pad, marble shovel, rag, water bucket, etc.;
3. Wax water, electrostatic vacuum cleaner, all-purpose cleaner, and stain-raising wax water.
③Special treatment (local stain):
Since the floor needs to be treated locally, ACL-5001 antistatic agent can be used. It is mainly used in dust-free machine
rooms and has low dust content. It is the best static destatic agent among the current electrostatic agents with the best
purification effect.
Electrostatic vacuum cleaner, all-purpose cleaner, stain-raising and wax-raising water.
④ Tools, detergents, and cleaning and maintenance methods required for flooring.
Cleaning method;
l The tools to be prepared;
. Machines that need to be prepared: one multi-function single wiper, one vacuum and water suction machine, wax
removal pad (white);
. Tools need to be prepared; two wax moppings, two wax buckets, one oak water bucket, one water push, and a mop;
. Cleaner that needs to be prepared; waxed water 6 gallons, 3M anti-static floor wax 6 gallons;
⑤Operation methods and procedures:
1) Wax removal method:
Use a mop to evenly apply the waxed water on the surface of the wax layer. After 5 minutes of action, you will see more and more milky white foam.
Use a floor scrubber equipped with a wax removal pad to clean the floor.
Clean the floor with a floor scrubber until the wax layer is not visible. If the wax layer is thick, it may not be cleaned at one time. You need to remove
it with wax water for a second time. Use a water absorber to suck the water dry.
Use a mop and clean water to wipe the floor several times. Be sure to wipe it clean to ensure that there is no residual waxed water on the floor to
avoid affecting the re-waxing effect.
⑥Daily cleaning and maintenance:
Tools required: 2 dust pushes, 2 mop
Cleaner that needs to be prepared: Then push the dust on the floor. If the local dirt is serious, you can wipe it with a moist mop that cannot be wrung
out of water.
Please note that the floor wax floor cannot be cleaned with water. If the anti-static floor wax floor wax floor has water accumulation, use a dry mop
immediately!
Note: The brand of the product used anti-static wax brand: 3M, etc.
Cleaner: DR7S01 Strong Wax Water, DR6G04 Electrostatic Vacuum, LF05 Strong Wax Water, LR01 Electrostatic Vacuum
※For the area of the IT computer room, there is an overhead electrostatic floor:
Summary: The static floor cleaning requires covering technology, that is, before the electrostatic floor cleaning construction, the waterproof floo
r protective film should be placed under the electrostatic floor with PVC + needle cotton, that is, the floor protective film. (The significance is great:
it can protect the secondary pollution of the construction personnel during the electrostatic floor cleaning construction, and the cleaning liquid can
penetrate from the gaps in the electrostatic floor to the ground, polluting the wiring trough or other lines under the electrostatic floor.) At the same
time, after cleaning an area, the ground protective film should also be covered on the cleaned electrostatic floor to protect the electrostatic floor
that is washed due to the movement of the personnel.
① Contents of electrostatic floor cleaning:

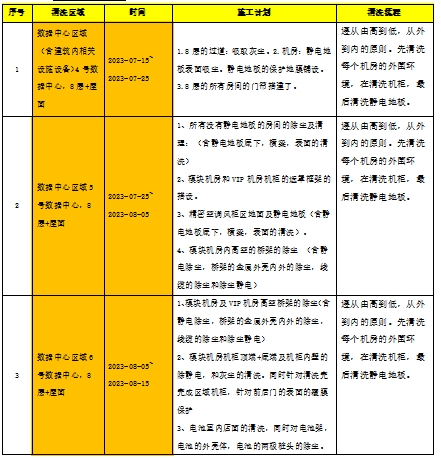

序号 | 阶段 | 目的 | 责任方 | 方法 | 标准 |
1 | 第1阶段-在拆除或初步施工(例如墙面安装的框架)时清洁 | 防止在以后的施工中难以到达的地方不必要的灰尘集中 | 如果建筑承包商在洁净室清洁方面没有相关经验,建议雇用专门从事洁净室清洁的专业清洁承包商 | 完成后进行真空清洁 | 外观干净 |
2 | 第2阶段-在公用事业安装过程中清洁 | 清除因安装电力,煤气等引起的局部污染物 | 安装工程师 | 真空清洁,完成后用湿抹布擦拭管道和固定装置。必须使用真空清洁和/或其他清洁材料 | 外观干净 |
3 | 第3阶段-早期施工中清洁 | 清洁天花板,墙壁,地板(过滤器安装架等)上所有可见的污染物。 完成施工和安装活动后。 | 清洁承包商 | 使用保护性地板密封剂进行真空清洁,刮擦的管道和带有潮湿刮水器的固定装置通常会产生颗粒,如果有必要,则应在此时使用。 | 外观干净 |
4 | 第四阶段-准备安装空调风管 | 在使用吸尘器和刮水器安装之前,先清洁管道部分的灰尘。同时,应向清洁剂施加正压。 | 安装工程师和清洁承包商 | 真空清洁,用湿抹布擦拭 | 刮水器-清洁 |
5 | 第5阶段-在将所有空气过滤器安装到系统中之前清洁 | 清除天花板,墙壁和地板上沉积的或沉降的灰尘,或同时清除两者 | 清洁承包商 | 用湿的雨刷擦拭 | 刮水器-清洁 |
6 | 第6阶段-将(hepa / ulpa)过滤器安装到空气系统中 | 消除安装过程中可能造成的污染 | 洁净室暖通过滤器工程师/技术员 | 清洁所有侧面的所有表面边缘 | 刮水器-清洁 |
7 | 第7阶段-调整空调设备。 | 清除气流中的悬浮灰尘,并建立超压装置,包括过滤器。 | 洁净室暖通过滤器工程师/技术员 | 空调空气冲洗操作 | 刮水器-清洁 |
8 | 阶段8-将房间升级为规定的等级。 | 清除每个表面上所有沉积和附着的灰尘(按天花板,墙壁,设备,地板的顺序排列) | 由专门按照法规,路线和行为构造的人员进行的专业洁净室清洁。 | 用湿的雨刷擦拭 | 刮水器-清洁 |
9 | 第9阶段-批准安装 | 验证洁净室是否符合规定的设计规范,客户接受 | 安装工程师和认证工程师/ | 监测空气和表面颗粒,空气湿度,温度和湿度 | 刮水器-清洁 |
10 | 第10阶段-清洁并定期 | 按照设计的分类长期保持洁净室的适应性。 | 洁净室经理/清洁承包商 | 在F.1至F.8中列出 | 刮水器-清洁 |
注意1:在第4到第10阶段,所有高效率和超高纯度组件,例如广告装配工,管道等,应在两边用塑料或绒毛覆盖物保护的现场使用,但仅在准备好时才将其取下 用来。 | |||||
注意2:在阶段6到10阶段,应按照规定的无尘室处理方法完成所有工作 | |||||
The high-compression laminate surfaces will be thoroughly cleaned using the approved electrostatic control formula
3M series, and then all surfaces will be treated with an active ion control formula to enhance and maintain electrostatic
control in the environment and then processed as needed.
②Cleaning of elevated floor system
oFloor ceiling and wall surrounding
oThe base and beam brackets of electrostatic floors
oBottom sealant
o Perforated floor tiles
o Data center glass wall
o Network bridge
oThe top outer surface of electrical equipment
oExternal fire extinguishing system
*All personnel training and applications comply with ISO standard 14644 and follow line flow technology with clean room
grade of 100,000 chemical mixing and processing safety.
Ceiling clean.
Note: Ceiling cleaning involves vacuuming over the ceiling ceiling by using a critical filter vacuum that complies with
recognized cleaning data center standards, and/or cleaning and wiping the cleaned top raceway environment using an
approved antistatic cleaner approved for data centers.
Anti-static floor finishing
Anti-static floor trimming involves the use of approved anti-static floor finishes on inactive floor surfaces to prevent
dangerous buildup of static electricity. Manufacturers of high pressure laminated (HPL) access flooring strongly recommend
not applying floor wax to the surface of access flooring.
The subfloor encapsulation includes applying an epoxy coating on the surface of the concrete subfloor boost chamber,
which acts as a vapor and dust barrier. Epoxy coatings should be applied manually to the surface of the subfloor. Installing
subfloor sealant is one of the best ways to reduce the concentration of particulate matter in the data center in concrete
dust and subsequent air.
Cleaning content of electrostatic floor:
l Surface of electrostatic floor
l Back of the electrostatic floor
l The joints of the electrostatic floor
l Scratches on the surface of the electrostatic floor
l Electrostatic floor underground
l Electrostatic floor bracket
③Dust removal process and process of electrostatic floor:
③Dust removal process and process of electrostatic floor:
Anti-static flooring, also known as dissipative electrostatic flooring, is a type of flooring that allows charge to be dissipated
when grounded or connected to any lower potential point, characterized by resistance between 5th power of 10th power to
9th power of 10th power. "GB 50174-2008 Electronic Information System Computer Room Design Specifications" stipulates:
The surface resistance or volume resistance of anti-static floors or ground should be 1 × l0 (5) ~1. 0 × 10 Ω.
The anti-static technology of computer rooms is part of the security and protection of computer rooms. Static electricity
generated by various reasons is one of the most frequent and difficult to eliminate hazards. Static electrostatic not only
causes random failures, malfunctions or calculation errors during the computer running, but may also lead to breakdown and
destruction of certain components, such as CMOS, MOS circuits, dual-stage circuits, etc. In addition, static electricity also has a
significant impact on the external equipment of the computer. Display equipment with cathode ray tubes will cause image
disorder and blurred when disturbed by static electricity. Static electricity can also cause modem, network card, Fax and other
work errors, printer printing abnormally, etc.
Not only is the problem caused by static electricity difficult for hardware personnel to detect, but sometimes it is also a
software personnel mistakenly believe that it is a software failure, which causes work chaos. In addition, when static electricity
discharges computers or other devices through the human body (so-called ignition) when the energy reaches a certain level,
it will also give people the feeling of electric shock (for example, sometimes when touching a computer monitor or chassis)
1. Testing before cleaning of electrostatic floors:
First use an impedance meter to measure the [impedance value] of the electrostatic floor of the project and print it out for
reference.
2 Electrostatic floor front cleaning:
First, use a vacuum suction pump to absorb large dust and pollutants from the entire electrostatic floor, then use a special
3M floor cleaning agent and a edge machine to clean the surface of the electrostatic floor, and then blow dry with a high-
power blower. (Please dry the excess water.)
3. Clean the back of the electrostatic floor:
Use a special 3M electrostatic floor cleaning agent and clean and dust removal. Remember not to scrub with water.
(The back of the electrostatic floor is made of steel, and it is easy to rust if you use water)
4 electrostatic floor beam cleaning:
First, use a vacuum cleaner to absorb the dust particles adhered to the crossbeam, and then clean it with 3M special
neutral cleaning solution. (The electrostatic beams are all copper-plated steel strips, and they will easily rust if they are water)
5 electrostatic floor bracket cleaning:
First, use a vacuum cleaner to absorb the dust particles attached to the bracket, and then clean it with 3M special neutral
cleaning solution. (The electrostatic brackets are all copper-plated steel strips, and they will easily rust if they are water)
6. Electrostatic floor underground:
Use a vacuum cleaner to absorb large residue, dust particles or contaminants such as thread under the electrostatic floor. Use 3M neutral cleaning solution with electric mop to clean the hard floor with dust-proof paint.
Anti-static flooring, also known as dissipative electrostatic flooring, is a type of flooring that allows charge to be dissipated when
grounded or connected to any lower potential point, characterized by resistance between 5th power of 10th power to
9th power of 10th power. "GB 50174-2008 Electronic Information System Computer Room Design Specifications" stipulates:
The surface resistance or volume resistance of anti-static floors or ground should be 1 × l0 (5) ~1. 0 × 10 Ω.
The anti-static technology of computer rooms is part of the security and protection of computer rooms. Static electricity
generated by various reasons is one of the most frequent and difficult to eliminate hazards. Static electrostatic not only
causes random failures, malfunctions or calculation errors during the computer running, but may also lead to breakdown and destruction of certain components, such as CMOS, MOS circuits, dual-stage circuits, etc. In addition, static electricity also has a significant impact on the external equipment of the computer. Display equipment with cathode ray tubes will cause image disorder and blurred when disturbed by static electricity. Static electricity can also cause modem, network card, Fax and other work errors, printer printing abnormally, etc.
Not only is the problem caused by static electricity difficult for hardware personnel to detect, but sometimes it is also
a software personnel mistakenly believe that it is a software failure, which causes work chaos. In addition, when static
electricity discharges computers or other devices through the human body (so-called ignition) when the energy reaches a
certain level, it will also give people the feeling of electric shock (for example, sometimes when touching a computer monitor
or chassis)
1. Testing before cleaning of electrostatic floors:
First use an impedance meter to measure the [impedance value] of the electrostatic floor of the project and print it out for
reference.
2 Electrostatic floor front cleaning:
First, use a vacuum suction pump to absorb large dust and pollutants from the entire electrostatic floor, then use a special
3M floor cleaning agent and a edge machine to clean the surface of the electrostatic floor, and then blow dry with
a high-power blower. (Please dry the excess water.)
3. Clean the back of the electrostatic floor:
Use a special 3M electrostatic floor cleaning agent and clean and dust removal. Remember not to scrub with water.
(The back of the electrostatic floor is made of steel, and it is easy to rust if you use water)
4 electrostatic floor beam cleaning:
First, use a vacuum cleaner to absorb the dust particles adhered to the crossbeam, and then clean it with 3M special
neutral cleaning solution. (The electrostatic beams are all copper-plated steel strips, and they will easily rust if they are water)
5 electrostatic floor bracket cleaning:
First, use a vacuum cleaner to absorb the dust particles attached to the bracket, and then clean it with 3M special neutral
cleaning solution. (The electrostatic brackets are all copper-plated steel strips, and they will easily rust if they are water)
6. Electrostatic floor underground:
Use a vacuum cleaner to absorb large residue, dust particles or contaminants such as thread under the electrostatic floor.
Use 3M neutral cleaning solution with electric mop to clean the hard floor with dust-proof paint.
7. Conventional surface treatment for anti-static floors:
Waxing method and construction process:
Regularly adding floor water wax can maintain the durability and anti-static properties of the floor. Before adding floor water wax, use a damp mop to clean the floor and worn areas. It is recommended to add one to two thinner anti-static floor water wax, and there should be sufficient drying time between each layer.
Remove stubborn stains on the ground, isolate the material itself from the air by waxing, reduce the damage caused to the
material by oxidation or contact with harmful substances in the air, and achieve the purpose of extending the service life of
the material and being beautiful and smooth.
(1) Necessity for waxing and polishing of anti-static floors:
Remove stubborn stains on the ground, isolate the material itself from the air by waxing, reduce the damage caused to the
material by oxidation or contact with harmful substances in the air, and achieve the purpose of extending the service life of
the material and being beautiful and smooth. More importantly, the mirror-bright surface it forms is particularly durable
and can prevent damage such as detergent, scratches, slips, heel friction, etc. At the same time, after polishing, the wax
surface is brighter and harder and more resistant.
(2) Anti-static floor waxing and polishing process:
First use the stain-raising and wax-raising water to clean the floor. First use the multi-functional floor brushing machine
and the vacuum-sucking water suction machine to clean the floor and use a three-speed air dryer to dry it; wooden floors,
etc. are used to cooperate with the vacuum-sucking water suction machine
Clean dust and electrostatic vacuum cleaner until clean;
Select the corresponding wax water according to the floor material, and waxing the floor with a waxing machine, a water
press and a wax mop;
l After the wax surface is dried, polish the wax surface;
l Dust removal treatment on the polished ground.
l Make a thorough and comprehensive inspection of the whole to ensure the quality of the project.
(3) Anti-static floor waxing and polishing equipment:
1. Multi-functional floor brushing machine, vacuum and water suction machine, three-speed air dryer, and polishing machine;
2. Water pressing truck, wax drag, dust push, cleaning pad, marble shovel, rag, water bucket, etc.;
3. Wax water, electrostatic vacuum cleaner, all-purpose cleaner, and stain-raising wax water.
8 Special treatment of anti-static floors (local stains):
Since anti-static flooring requires local treatment, ACL-5001 antistatic agent can be used. It is mainly used in dust-free
machine rooms and has low dust content. It is the best static destatic agent among the current electrostatic agents with
the best purification effect.
Electrostatic vacuum cleaner, all-purpose cleaner, stain-raising and wax-raising water.
Tools, detergents, and cleaning and maintenance methods required for anti-static flooring.
Cleaning methods for anti-static flooring;
l The tools to be prepared;
. Machines that need to be prepared: one multi-function single wiper, one vacuum and water suction machine, wax
removal pad (white);
. Tools need to be prepared; two wax moppings, two wax buckets, one oak water bucket, one water push, and a mop;
. Cleaner that needs to be prepared; waxed water 6 gallons, 3M anti-static floor wax 6 gallons;
Work methods and procedures:
1) Wax removal method:
Use a mop to evenly apply the waxed water on the surface of the wax layer. After 5 minutes of action, you will see more and
more milky white foam. Use a floor scrubber equipped with a wax removal pad to clean the floor.
Clean the floor with a floor scrubber until the wax layer is not visible. If the wax layer is thick, it may not be cleaned at one
time. You need to remove it with wax water for a second time. Use a water absorber to suck the water dry.
Use a mop and clean water to wipe the floor several times. Be sure to wipe it clean to ensure that there is no residual
waxed water on the floor to avoid affecting the re-waxing effect.
2) Procedure for waxing anti-static floor wax:
After the ground is completely dry, pour an appropriate amount of anti-static wax into the wax bucket, drag the wax to
moisten with wax water and twist it dry. According to the principle of from the side to the inside and from the inside to
the outside, let the wax drag run according to the ∞ shape. Be careful not to dip too much or too little wax each time.
Apply evenly and do not miss it. After the wax layer is completely dry, apply the second wax as the same method. Dry
standards: non-stick to your hands and non-stick to your feet. Polish it after it is completely dry: choose a multi-function
single wiper to polish it with a red polishing pad, and run it slowly during polishing.
Daily cleaning and maintenance:
. Tools required: 2 dust pushes, 2 mop
Cleaner to prepare: electrostatic floor dust collector
Then use dust to push the dust on the floor. If the local dirt is serious, you can wipe it with a moist mop that cannot be
wrung out of water.
Please note for maintenance: Anti-static floor wax floor cannot be cleaned with water. If water accumulates on the anti-static
floor wax floor, use a dry mop immediately!
Work cycle suggestions: It is usually done once every three months, the main credentials:
Can work be stopped and waxing can be stopped?
Is it necessary to rewax the wax surface?
Whether the anti-static wax conductivity has decreased and it is necessary to waxing;
Whether the wax layer is damaged by friction.
Note: The brand of the product used anti-static wax brand: 3M, etc.
Cleaner: DR7S01 Strong Waxed Water, DR6G04 Electrostatic Vacuum Refrigerant, LF05 Strong Waxed Water, LR01 Electrostatic
Vacuum Refrigerant.
Attachment 1: Related standards for computer room construction and their sources
【State Law】
National Security Law of the People's Republic of China
"Regulations on Security Protection of Computer Information Systems of the People's Republic of China"
"Interim Provisions on the Management of International Networking of Computer Information Networks of the People's
Republic of China"
Law of the People's Republic of China on Conservation of State Secrets
National Security Law of the People's Republic of China
【National Regulations】
"Decision to Maintain Internet Security"
Regulations on the Security Protection of Computer Information Systems of the People's Republic of China
China Information Security Product Evaluation and Certification Standards Catalog (I)
Military Computer Security Assessment Guidelines GJB2255-95
Regulations on Information Network Security Management of Ministry of Land and Resources
Security Policy Analysis Report_Sample
Electronic computer room construction and acceptance specifications sj
Electronic computer room design specification GB50174-2017
Interim Regulations on the Management of International Network Networks
Regulations on the confidentiality management of computer information systems international networking
Principles for classification of special products for computer information system security (GA163-1997)
Computer information system security product components (safety function detection GA216-1-1999)
Standards for the classification of security protection levels of computer information systems GB 17859-1999
Technical requirements for computer information system security level protection operating system (GAT388-2002)
Technical requirements for computer information system security level protection database management system (GAT389-2002)
Computer information system security level protection management requirements (GAT391-2002)
Technical requirements for network protection of computer information system security level (GAT387-2002)
General technical requirements for security level protection of computer information system (GAT390-2002)
Computer Software Protection Regulations
GB9361_1988 is required to calculate the site safety of the station.
请拨打全国免费咨询热线:400-160-6690,联络我们的专业销售人员,其他更多信息,请浏览公司官网(www.cd-estt.com)
Chengdu estt Technology in China;
Japan big data dust removal;
Japanese server dust removal;
Japanese switch removal;
Japanese UPS dust removal;
Japanese Static floor cleaning
South Korea big data dust removal;
South Korea server dust removal;
South Korea switch dust removal;
South Korea UPS dust removal
South Korea static floor cleaning
Singapore big data dust removal;
Singapore server dust removal;
Singapore switch dust removal;
Singapore UPS dust removal;
Singapore static floor cleaning
Malia big data dust removal;
Malaysia server dust removal;
Malaysia switch dust removal;
Malaysia UPS dust removal;
Malaysia static floor cleaning
India big data dust removal;
India server dust;
India switch dust removal;
India UPS dust removal;
India static floor cleaning
Taiwan big data dust removal;
Taiwan big data dust removal;
Taiwan switch dust removal;
UPS dust removal;
Taiwan static floor cleaning
Hong Kong big data dust removal;
Hong Kong server dust removal;
Hong Kong switch dust removal;
Hong Kong UPS dust removal
Hong Kong static floor cleaning
Macao big data dust removal;
Macao server dust removal;
Macao switch dust removal;
Macao UPS dust removal;
Macao static floor
Philippines big data dust removal;
Philippines server dust removal;
Philippines switch dust removal;
Philippines UPS dust removal;
Philippines static floor cleaning
Vietnam big data removal;
Vietnam server dust removal;
Vietnam switch dust removal;
Vietnam UPS dust removal;
Vietnam static floor cleaning

(Tel):+86-028 - 85433824/ 85434834/ 85572715/ 855592596/ 85074844 (Fax):+86-028- 85572715-8010 / 8011 Copyright © ESTT Tech All Rights Reserved 2008-2025. For more information, please visit the company's official website (www.dyestt.com) 蜀ICP备16017795号
ABOUT 丨 MESSAGE 丨 CONTACT US
